Quick Answer: Container pricing in Canada in 2026 falls into four grade bands: One-Trip (new) at the top, then Cargo Worthy, then Wind & Watertight, then As-Is at the bottom. What you pay depends on size, grade, delivery distance, and the steel market, so an honest yard quotes each order rather than posting a number that goes stale.
Van Blanc has supplied containers from its Brantford yard since 1995, holds 4.9 stars across 140+ Google reviews, and delivers Ontario-wide in 1-3 days.
Why two Canadian price guides can disagree by a factor of two
Search for what a shipping container costs in Canada and you will be handed confident numbers. Read two of those guides side by side, both published for 2026, both about Canadian buyers, and something awkward emerges: their ranges for a new 20ft container do not overlap at all. The top of one sits below the bottom of the other, a gap of roughly two to one on the same product in the same country in the same year.
Neither guide is dishonest. Both are accurate snapshots of a system that will not hold still, and understanding the four forces underneath is worth more to a buyer than any single number either of them printed.
| Force | What it does to the number you are quoted |
|---|---|
| Steel input cost | Corten steel is roughly 60 percent of what it costs to build a container, so new-unit prices track global steel indices rather than local demand |
| The exchange rate | Canadian inventory is bought in US dollars. A weaker loonie raises the Canadian price with no change whatever to the container |
| Trade volumes | Availability follows international freight flows, so a slow shipping season tightens or loosens supply months later |
| Trade policy | Tariffs and customs treatment change landed cost independently of everything above |
Look at the second row for a moment, because it is the one that catches people. A container sitting in a Canadian yard, already imported, already inspected, unchanged in every physical respect, is worth a different number of Canadian dollars this month than last, purely because the currency moved underneath it. Any guide that prints a range is publishing an exchange-rate position with a short shelf life, whether or not it says so.
That is the honest reason we quote rather than publish a price list. A number posted on this page would be a promise about steel indices and currency markets that we are in no position to make, and you would find it out of date at exactly the moment it mattered. What we can promise is a real figure for a real unit on the day you ask, which is why every enquiry goes through a direct quote and why our plain-language guide to the four grades matters more than any range: grade moves the number further than the calendar does.
The season you buy in is a lever you control
One of the four forces is genuinely in the buyer’s hands. Demand is seasonal, and it is predictable: prices firm through spring as construction season opens and yards compete for the same inventory, and they soften through the colder months when the phone rings less. The trade guidance for construction firms is blunt about it, naming winter as the window in which a buyer has room to negotiate, particularly on volume.
For anyone whose need is not urgent, that is a real and free advantage. A container bought in February and left on the yard until April costs less than the identical container bought in April, and the only thing you spent was patience. If the job is fixed to a spring start, work backwards and buy early rather than into the peak. We will hold and deliver to your schedule, and the honest version of that conversation is one we would rather have in January than in May.
In This Guide
- How is a shipping container price built in Canada?
- How much does a sea can cost?
- What are the four container grades, and how does grade affect price?
- How big is a shipping container, and how does size affect price?
- How does the cost ladder run from 20ft to 40ft to 53ft?
- Does cosmetic wear on a used container affect the price?
- Are shipping containers cheaper in Quebec or BC than in Ontario?
- Market trends 2020 to 2026: from the spike to the new normal
- Container market snapshot: updated August 2026
- Why shipping cost sits inside the sticker price
- Modification cost markup: the layer most pricing guides skip
- Should you rent or buy a shipping container?
- Financing impact on total cost of ownership
- Hidden fees and how an honest yard quotes them
- The Facebook trap and other Canadian scams
- Detailed topic guides: spokes from this hub
- Frequently asked questions
Reading time: about 22 minutes.

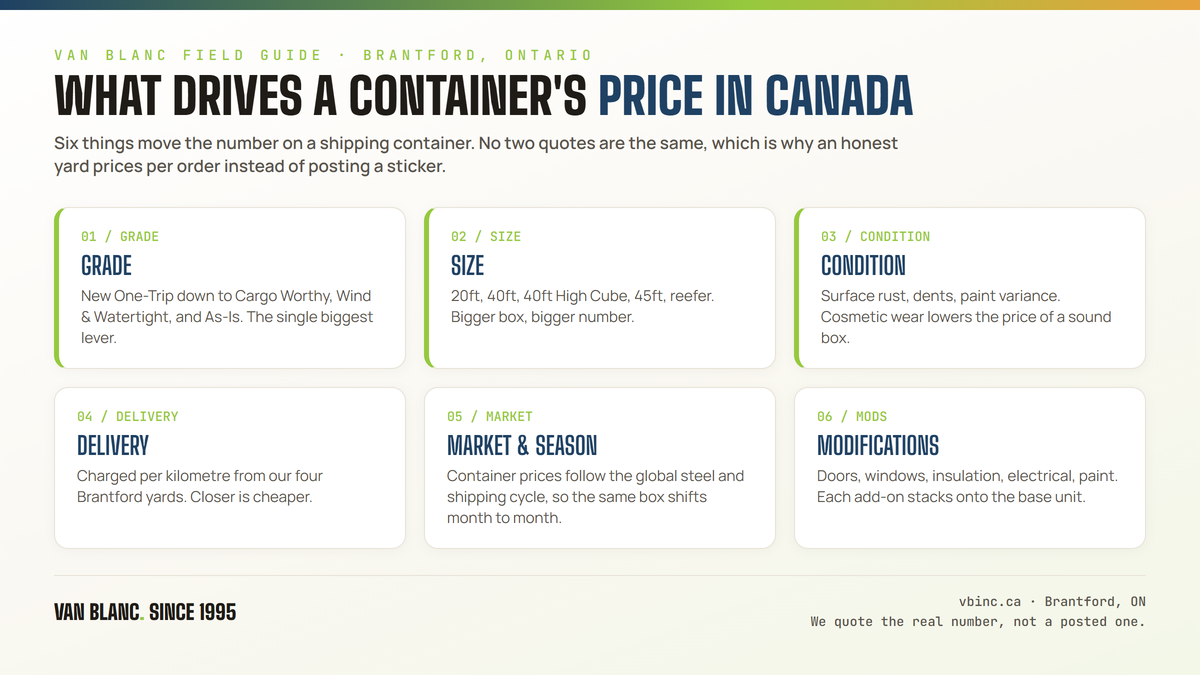

How is a shipping container price built in Canada?

A shipping container price in Canada is not a single number. It is a stack. The steel cost at the factory in China or Vietnam sits at the base. On top of that, ocean freight from Asia to a North American port. Then drayage off the port to an inland yard like ours in Brantford. Then yard handling, inspection, grading, and storage. Then any modification work the buyer wants. Then delivery to the buyer’s site. By the time a container reaches your driveway, every one of those layers has added cost. Two decisions set where you land on that stack: whether you want a new one-trip box or a used grade, and whether you buy or rent at all.
Most pricing guides on the internet flatten this stack into a single sticker number. We do not, because buyers who only see the sticker number get burned when the bill at the gate is 40 percent higher than the listing they clicked on Facebook. The honest move is to lay the stack out, explain the grades, and tell you which box you actually need for your project before anyone takes a deposit.
That is what this pricing reality across container grades guide does. It is the umbrella piece. Specific spokes below cover one-trip pricing, calculator math, negotiation tactics, age framework, scrap value, auction prices, refurbished options, and condition grading in depth. Use this hub to orient. Use the spokes to drill into the band you care about.
The five layers inside every container quote
1. Steel cost at origin (factory price, Asia). 2. Ocean freight to Canadian or US port. 3. Inland drayage to the supplier yard. 4. Yard handling, grading, and storage. 5. Last-mile delivery to your site. Reefers add a sixth layer (refrigeration unit cost). Modifications add a seventh. Every honest supplier should be able to break the quote into these layers if you ask. If they cannot, that is information.
How much does a sea can cost?
A sea can costs whatever the same shipping container costs: sea can is simply the Canadian name for the identical ISO steel box, so sea can prices run the identical ladder, new (one-trip) at the top, then Cargo Worthy, then Wind & Watertight, then As-Is. Five inputs set your number: grade, size, delivery distance from the yard, the current steel and freight markets, and any modifications. A 20ft Wind & Watertight is the cheapest honest way into container ownership; a new (one-trip) 40ft High Cube is the top of the ladder. Nobody can quote a sea can accurately without your postal code, which is why we price each order live: call the Brantford yard at 519-754-6844 or request a quote and we will send back a real, all-in number, usually the same day.
What are the four container grades, and how does grade affect price?
The four grades exist for a reason, and if you want the full picture before you read on, our overview of how the grades and box types actually differ lays out the taxonomy in plain language. Each one is priced against the specific use case it is good for. Get the grade right and you save thousands. Get it wrong and you either overpay for a one-trip when a Wind & Watertight unit would have done the job, or you underpay for an As-Is and discover the floor is rotten the day after delivery.
Here is the 2026 Canadian band reality, observed across our Brantford yard inventory and verified against published trade pricing guides from Ontario Construction News, ATS Containers, and Metropolitan Logistics.
| Grade | Relative cost | Condition | Right use |
|---|---|---|---|
| One-Trip / New | Highest | Single ocean crossing, factory paint, no rust, 25+ year life | Office, retail, residential conversion, branded use |
| Cargo Worthy (CW) | Upper-middle | Multiple crossings, structurally sound, surface rust and paint variance | Export, heavy-duty industrial storage |
| Wind & Watertight (WWT) | Lower-middle | Cosmetic wear, doors seal, floor clean, not re-certified for export | Farm storage, equipment shelter, on-site reno |
| As-Is | Lowest | Known issues: floor, frame, or door problems | Scrap reuse, structural donor, low-stakes storage |
The gap between One-Trip and used is what most buyers misread. A One-Trip container has made a single ocean crossing loaded with cargo. It is essentially new. Original factory paint, no rust, doors that operate cleanly. A Cargo Worthy container has crossed the ocean multiple times and is still structurally sound for export. A Wind & Watertight container has cosmetic wear but the doors close, the panels seal, and the floor is clean. An As-Is unit has known issues, sold cheap for buyers who know exactly what they want to do with damaged steel.
None of these grades is dishonest if it is described accurately. A Wind & Watertight unit listed as WWT, with honest photos of the rust spots, is fair dealing. A WWT painted up to look like a one-trip and sold at a one-trip quote is the scam Paul has watched repeat for two decades.
Paul LeBlanc, owner: “I have watched the container market through every cycle since I entered the industry. The grades have not changed in 19 years. The prices move with steel, freight, and demand, but the grade taxonomy is the same one I learned in 2007. If anyone offers you a fifth grade that sounds too good to be true, walk away.”
How big is a shipping container, and how does size affect price?
Size compounds with grade. A One-Trip 40ft High Cube is not just a bigger box than a 20ft Standard. It is the most popular configuration in North America, which means demand sits on top of demand, and the price reflects that. For the full dimensional breakdown of every length, see our complete container sizes and dimensions guide. A 10ft container, on the other hand, is a custom cut from a 20ft and ends up costing more per linear foot than the parent unit.
| Size | External dims (L × W × H) | Volume | Relative cost driver | Notes |
|---|---|---|---|---|
| 10ft | 3.0 m × 2.44 m × 2.59 m | ~16 m³ | Premium per foot | Custom-cut from a 20ft, so it costs more per linear foot than its parent unit |
| 20ft Standard | 6.06 m × 2.44 m × 2.59 m | 33.2 m³ | Baseline | Most flexible size, easiest to site |
| 20ft High Cube | 6.06 m × 2.44 m × 2.90 m | 37.4 m³ | Adds over 20ft Standard | Less common; the extra foot of headroom carries a premium |
| 40ft Standard | 12.19 m × 2.44 m × 2.59 m | 67.7 m³ | Better value per m³ | Industry workhorse for high-volume storage |
| 40ft High Cube | 12.19 m × 2.44 m × 2.90 m | 76.3 m³ | Demand-driven premium | Most popular size globally in 2026 |
| 45ft High Cube | 13.71 m × 2.44 m × 2.90 m | 86.0 m³ | Scarcity premium | Premium; fewer in circulation |
| 20ft Reefer | 6.06 m × 2.44 m × 2.59 m | ~28 m³ usable | Refrigeration unit drives the cost | Working Carrier or Thermo King genset sets the value, not the steel |
| 40ft HC Reefer | 12.19 m × 2.44 m × 2.90 m | ~67 m³ usable | Refrigeration unit drives the cost | Cold-chain workhorse |
Two patterns matter for sizing, and if you are still deciding between footprints, it helps to compare the dimensions side by side before you weigh the cost. First, the 40ft High Cube is now the global default because it ships more cargo per crossing than any other dry container. That demand keeps the price stable even when steel costs dip. Second, reefers carry a premium that has almost nothing to do with the steel and almost everything to do with the refrigeration unit. A reefer in good condition with a working Carrier or Thermo King genset is worth four to six times its dry-container equivalent.
For the deepest spoke on one-trip pricing in particular, see our breakdown of what actually justifies the premium on a new box.
How does the cost ladder run from 20ft to 40ft to 53ft?
Size moves the number less than most buyers expect, because the box is only one line in the quote. How the ladder actually behaves:
- 20ft: the entry point and the easiest delivery. Shorter trailer, tighter driveways, the default pick for residential storage. Supply is deepest here, which keeps the grade spread honest.
- 40ft and 40ft High Cube: the workhorse commercial sizes. Per cubic metre of storage, one 40ft usually beats two 20fts: one steel box, one delivery, one set of doors. High Cube adds a foot of height for a modest premium and is the default shell for conversions.
- 53ft: a domestic North American size, scarcer than the ISO sizes, so availability drives the quote more than steel does. When a 53ft is the right call (long racking runs, dead storage for a full trailer load) the per-cubic-metre math lands in its favour; when it is not, two 40fts win on delivery flexibility.
Full measurements live in the sizes and dimensions hub, and every size has a spec page: 20ft, 40ft, 40ft High Cube, 53ft High Cube.
Does cosmetic wear on a used container affect the price?
Cosmetic condition is where most buyers get nervous and where honest yards earn their reputation. A used container does not look like a new car. There will be rust spots. There will be paint variance from where prior owners stencilled and re-stencilled. There may be a small dent in a panel. None of that is structural damage. Structural damage means floor failure, frame distortion, door seal failure, or rust-through on a load-bearing member.
Christian walks every used container at our yard before it lists. He is looking at six things: floor condition, door operation, panel rust depth (surface vs perforation), corner casting integrity, roof straightness, and seal contact. If a container fails any of those, it gets routed to As-Is or scrap, not WWT or CW. That sorting is what makes the price honest, and it is the same checklist we walk first-timers through in our step-by-step advice for buyers approaching their first purchase.
The cosmetic surcharge that does not exist
Some Ontario yards charge an extra for “good cosmetic condition” on used inventory. That is a markup, not a grade. Wind & Watertight already includes a cosmetic floor. If a yard is upcharging you for “extra clean WWT,” ask which structural inspection delivered that grade and how it differs from regular WWT. The honest answer is usually nothing.
If you want the deeper breakdown on age and condition together, our container age buying framework walks through how to read date plates, what an 8-year-old WWT actually means, and when paying more for a 15-year unit is still the right move.
Are shipping containers cheaper in Quebec or BC than in Ontario?
Canadian container pricing is not flat. Where the box landed affects what it costs. Containers entering through the Port of Montreal flow into Quebec inventory first, which is why CW and WWT pricing in Quebec frequently sits 5 to 10 percent below Ontario. Containers entering through Vancouver flow into BC inventory first, with similar regional discount. Containers entering through Halifax flow into Atlantic Canada, sometimes with a long-haul markup if they cross provincial lines.
Ontario is the country’s primary logistics corridor. Rail intermodal terminals across the GTA mean inventory is dense, but density does not always mean cheaper. Buyers in southwestern Ontario, our home region, typically pay middle-band pricing because the freight cost from port to Brantford is built into every unit we yard.
| Region | Relative used-container cost | What drives it | Notes |
|---|---|---|---|
| Quebec (Montreal corridor) | Often 5 to 10 percent below Ontario | Port-of-Montreal intake | Port-of-Montreal landed inventory |
| Ontario (Brantford / GTA) | Stable middle band | Densest inventory pool | Densest inventory, stable pricing |
| British Columbia (Vancouver) | Often below Ontario | Port-of-Vancouver intake | Port-of-Vancouver landed inventory |
| Alberta (Calgary / Edmonton) | Higher than coastal regions | Long-haul rail markup from coast | Inland, no direct port intake |
| Atlantic Canada (Halifax) | Varies with a smaller pool | Port-of-Halifax intake | Smaller inventory pool |
| Northern provinces / territories | Highest, freight-dominated | Freight premium dominates the stack | Distance is the largest cost line |
If a buyer in Sault Ste Marie or Thunder Bay calls our Brantford yard, the question is always whether the freight saved by going to a closer local yard offsets the inventory premium they pay there. Most of the time, southwestern Ontario inventory plus Ontario-wide freight still beats Northern Ontario yard pricing for buyers ordering more than two units at a time.
Market trends 2020 to 2026: from the spike to the new normal
You cannot read 2026 pricing without understanding what happened between 2020 and 2024. The pandemic-era supply shock pushed 40ft One-Trip prices in Canada to roughly double their pre-pandemic level at the peak in mid-2021. New container production in Asia was constrained, ocean freight rates from Asia to North America hit historic highs, and demand for storage-in-transit spiked because supply chains were jammed everywhere. A buyer who walked into any Ontario yard in summer 2021 paid roughly double what the same unit costs today.
By late 2022 the spike had broken. Ocean freight rates fell back. Asian production came back online. North American yards that had been buying inventory at peak prices were sitting on units they had paid too much for, and they did not want to sell at a loss. That mismatch is why some yards still try to quote 2021 prices today. They are working through old inventory.
2024 and 2025 were the stabilization years. Prices came back to roughly pre-pandemic levels, adjusted for steel inflation. 2026 is the new normal: market is balancing out after years of volatility, prices higher than pre-COVID but well below the 2021 peak. Industry analysts forecast 3 to 4 percent annual growth through 2027, with Panama Canal, Suez Canal, and Red Sea disruptions still capable of generating short-term spikes.
What a 2026 buyer should ignore
Any guide written before 2023 quotes peak-era prices that do not reflect today’s market. Any guide from late 2022 or early 2023 reflects the crash. Use 2025 or 2026 sources only when reading current pricing. The same applies to listings: a Facebook listing showing a 2021 photo with a 2021 price is not a deal, it is an inventory ghost.
Paul has seen four cycles in the container business since he started in 1995, and four more before that during his Asian-trade years. His read on 2026 is simple. The volatility is gone, the cost of steel is steady, the freight market is stable, and the buyer who waits for “another crash” is going to wait a long time. If you need the box now, the price you see now is the price.
| Year | One-Trip price direction | Market context |
|---|---|---|
| 2019 | Baseline | Pre-pandemic baseline, stable demand |
| 2020 | Rising | Early COVID supply disruption |
| 2021 (peak) | Peak, roughly double baseline | Global supply shock, ocean freight historic high |
| 2022 | Falling sharply late Q3 | Crash begins late Q3, inventory glut |
| 2023 | Settling | Stabilization year, yards working through old stock |
| 2024 | Near pre-pandemic, adjusted for steel | New normal forming, modest steel inflation |
| 2025 | Stable, brief spikes | Stable, with brief Red Sea routing spikes |
| 2026 | Stable, slow growth | Stable band, 3 to 4 percent annual growth forecast |
The historical band above is averaged across honest Canadian supplier yards, not retail-listing prices on Facebook or Kijiji. Listing prices in 2021 occasionally went higher than the band shows because individual sellers tried to ride the spike. Yard pricing tracks the wholesale-replacement cost more closely, which is why the 2026 numbers reflect what it actually costs to land a fresh container in a Brantford yard, plus the margin a 30-year independent supplier needs to keep the doors open.
Container market snapshot: updated August 2026
Three third-party indexes tell you which way container prices are leaning right now, with no stale sticker price required:
- Ocean freight: the Drewry World Container Index fell 3 percent in the July 30 reading, its second straight weekly decline, as capacity surged back onto the east-west lanes and demand softened under the newest round of US tariff measures. The early-July spike unwound inside a single month. Freight feeds the landed cost of every new (one-trip) box that reaches Ontario.
- Steel: Shanghai rebar futures eased to roughly 3,060 CNY per tonne by July 30 after touching a one-month high of 3,130 mid-month (Trading Economics), with weak Chinese property demand doing the pulling. Container factory pricing in China tracks steel with a lag of one to two quarters.
- Depot supply: Container xChange’s June 2026 North America outlook still shows uneven depot-level supply across Toronto, Montreal, and Vancouver, with 40ft High Cubes the tightest corner. Carriers began announcing emergency fuel surcharges for August sailings, a wildcard that lands on landed cost before it shows in any posted price.
What that means for an Ontario buyer this quarter: the direction turned soft in late July after a firm start to the month, and a buyer with flexible timing may see friendlier landed costs on new (one-trip) stock arriving later in the year. Tariff and surcharge noise is moving quotes week to week, in both directions. That is the whole argument for a live quote over a posted price.
Why shipping cost sits inside the sticker price
The container you buy in Canada was probably built in Qingdao, Ningbo, or Vietnam. To get from a factory in Asia to your Ontario driveway, that 20ft box of steel had to make four journeys: factory truck to Asian port, ocean ship to a North American port, drayage from the port to an inland yard, and finally delivery from that yard to you. Each leg adds cost. The sticker price you see when you browse the bins we have in the yard is the result of those four legs already added up.
Ocean freight from Shanghai or Shenzhen to Toronto or Montreal remained a meaningful cost line in early 2026, with the 40ft rate running higher than the 20ft rate port-to-port, per the Metropolitan Logistics 2026 rate sheet. That is just the ocean piece. Add inland rail or truck drayage to the supplier yard, customs brokerage, terminal handling fees, and the supplier’s own margin, and you understand why a One-Trip unit always lands well above the bare factory steel cost.
This is also why the last-mile delivery from the yard to the buyer’s site is quoted separately. Our delivery fee depends on distance, route, and tilt-deck access. Quoting last-mile inside the unit price would hide the variable. We quote it out so the buyer can see exactly what they are paying for.
The Brantford freight reality
From our 4 Brantford yards, we deliver across Ontario in 1 to 3 days. Hamilton is a short last-mile haul. Toronto and the GTA proper vary with driveway access and tilt-deck requirements. Kitchener-Waterloo and Cambridge sit in the close-in band. Brockville and Kingston cost more because the haul is roughly four hours each way. Northern Ontario routes are quoted per route because freight dominates the price stack at that distance. Every quote includes a real lead time, not a hopeful one.
One layer that buyers sometimes miss is the cost of bringing a container off a tilt-deck onto a prepared pad versus craning it down onto a tighter site. A standard tilt-deck delivery requires roughly 100 feet of clear backing space plus the container length. If the site is tighter than that, a crane truck is the alternative, and a crane placement costs more than a standard tilt-deck drop. Cottage country and downtown urban deliveries hit this surcharge more often than rural farm deliveries do.
Modification cost markup: the layer most pricing guides skip
If you are converting a container into something useful, the unit price is half the conversation. The modification work is the other half, and most generic pricing guides skip it entirely because the markup varies wildly by shop.
| Modification | What’s included (drives the cost) | Who certifies |
|---|---|---|
| Personnel door cut and install | Steel cutting, frame, hinged door, weather seal | Built at our yard |
| Window cut and install (per window) | Frame, sealed glazing, exterior trim | Built at our yard |
| Roll-up door (man-door size) | Opening cut, frame, roll-up unit, install | Built at our yard |
| Roll-up door (full end-wall) | Replaces cargo doors, common for retail conversions | Built at our yard |
| Spray foam insulation (R-20+, full 20ft) | Closed-cell, condensation-blocking | Built at our yard |
| Spray foam insulation (R-20+, full 40ft) | Closed-cell, condensation-blocking | Built at our yard |
| Electrical (basic 100A panel, outlets, lights) | Panel, circuits, receptacles, lights | Roughed-in by us, finished and ESA-certified by a licensed electrician |
| HVAC mini-split (12,000 BTU) | Condenser, head, refrigerant line | Roughed-in by us, connected by a licensed trade |
| Interior framing and drywall (full 20ft) | Studs, vapour barrier, drywall, paint | Built at our yard |
| Plumbing rough-in (single fixture) | Supply, drain, vent (cottage / off-grid scope larger) | Roughed-in by us, finished by a licensed plumber |
| Exterior paint (full container, 2 coats) | Industrial enamel; brand colour matching is more involved | Built at our yard |
A fully converted 20ft container office, with a door, two windows, spray foam, electrical, HVAC, framing, drywall, and paint, adds a substantial layer on top of the One-Trip unit cost. A full container home build adds more again, depending on finish level. In both cases the container itself is the smallest line in the budget.
Honest modification work has a 30 to 50 percent markup over raw cost when delivery, drayage, and site prep are included, per industry pricing references. That markup pays for the welders, the certified electrician, the engineered drawings if needed, and the warranty on the finished work. A shop that quotes you 10 percent markup is either cutting corners or hiding fees elsewhere.
The reason modification cost surprises so many first-time buyers is that the container itself looks like the big purchase. Steel is heavy, the box is enormous on a delivery trailer, and the sticker on the unit feels substantial. But the moment you cut a single door into that steel, you are paying for a welder’s time, a fabricated door frame, a weather seal, a hinged door, and the touch-up paint. That sequence repeats for every window, every roll-up, every penetration for electrical or plumbing. The labour and parts stack up fast.
What an honest modification quote should itemize
Base container price, separated. Each cut and install, line by line, with hours and material listed. Spray foam coverage in board-feet or square-feet, with R-value spec. Electrical scope (panel size, number of circuits, receptacles, lights), with ESA certification fee broken out if needed. HVAC unit make/model and install. Engineered drawings if the conversion is occupied. Site delivery, separate. Tax line. A reputable shop will quote you all of that on a single page so you can see where every dollar goes.
Should you rent or buy a shipping container?
Run the break-even test. National rental programs publish break-even points around 20 to 27 months, meaning if you will need the space for roughly two years or longer, buying wins, and you still own the box at the end. A rental company wins for a defined short window: a renovation season, a single site cycle, a staged move, and Van Blanc does not rent, so we will point you there when that is the honest answer. Commercial rent-to-own through our third-party financing partner is the middle path for businesses when cash flow matters more than total cost. The deep dives: what drives rental cost, what it actually costs to rent a shipping container in Ontario, how rent-to-own actually works, and why we sell instead of rent. Tell us the job and the timeline and we will tell you honestly which path fits. Sometimes the answer is rent, and we will say so, and tell you who does.
Financing impact on total cost of ownership
Most Canadian container buyers pay cash. Our COD policy is part of why customers like working with us, and paying up front saves them the interest stack that financing would add. But not every buyer can cover the full purchase in a single transaction, so understanding financing impact on total cost matters even when it is not your first choice.
Three financing paths and what they actually cost
- Commercial lease (24 to 60 months): Typically used by farms, contractors, and small businesses. Adds roughly 8 to 15 percent in total interest over the lease term. Often deductible as a business expense, which softens the bite.
- Bank or credit union loan (secured): Lower interest (5 to 8 percent over current prime) but requires collateral. Total cost markup runs 10 to 20 percent over a 5-year term.
- Rent-to-own programs: Common nationally, less common at independent yards. Adds 30 to 60 percent over the cash price by the time ownership transfers. Good for buyers with no cash and no credit line, expensive otherwise.
If you have the cash, COD remains the cheapest path. If you need financing, a bank loan secured against business assets is usually the cheapest financing path. Rent-to-own is the most expensive but the most accessible.
Total cost of ownership across a five-year horizon also includes maintenance, which most buyers underestimate. A working container does not need much, but it needs a little. Roof inspection annually for ponding-water rust. Hinge oiling every six months. Touch-up paint on cosmetic rust spots before they perforate. Floor sealant every three to five years if the container is occupied. None of these line items is large on its own. Added up over five years, they form a modest soft-maintenance cost that should sit alongside the purchase price in your budgeting.
Hidden fees and how an honest yard quotes them
A container quote should have no surprises. In our 30 years operating Van Blanc, the fees most commonly hidden by competitors are: delivery, tilt-deck access surcharge, site-prep consultation, inspection fee for used inventory, paperwork fee, terminal handling at the source yard, and storage fee if the buyer cannot take delivery within X days.
Our quote breaks these out line by line. A 20ft WWT with a Brantford-to-Hamilton delivery fee and a tilt-deck access charge is a transparent quote. A 20ft WWT “delivered” is a quote that has hidden the same fees in the unit price, and the buyer cannot tell where the cost is going. The math ends up the same. The honesty is different.
For a clean way to work out what a used unit should honestly cost you delivered, our resale calculator walkthrough does the math step by step.
What every honest quote should include
Unit price by grade. Delivery cost broken out by distance and access type. Tax line. Optional add-ons (lock box, lift handles, paint touch-up). Payment terms (cash, draft cheque, wire, credit card). Real lead time, not a hopeful one. Yard address you can visit before paying. If any of those are missing, ask. If the answer is vague, walk.
Ready to price your container?
Tell us the size and your postal code and we’ll send back an honest, all-in number, container, delivery, and placement, usually within 1-3 days. No pressure, no mystery fees.
Family-run in Brantford since 1995 · 200+ containers in stock · 4.9★ across 140+ Google reviews · every box graded by a person, walk it before it lands.
The Facebook trap and other Canadian scams
The Facebook trap is the single most common scam in the Canadian container market. Many people call us saying they found a bin far cheaper on Facebook Marketplace. Two weeks later they call back saying they got scammed. Paul has seen this exact pattern weekly for two decades.
The mechanism is simple. A scammer lists a 20ft container well below honest WWT pricing on Facebook Marketplace or Kijiji. The buyer asks for photos and delivery. The scammer sends generic yard photos pulled from real supplier websites, then asks for an Interac e-Transfer deposit. The buyer sends the deposit. The listing disappears, the scammer’s account closes, the container never arrives. We see the call-back two weeks later, every time.
Six red flags that mean walk away
1. Price more than 25 percent below honest market band. 2. Seller refuses to give a physical yard address. 3. Seller insists on Interac e-Transfer (untraceable, unrecoverable). 4. Photos look generic or pulled from another website (reverse-image search them). 5. Urgency pressure (“three other buyers are interested”). 6. No paperwork, no invoice, no CSC plate photo. If you see two of these, walk. If you see three, you are looking at a scam.
The Canadian Anti-Fraud Centre tracked hundreds of millions of dollars in reported fraud losses in 2024, with online merchandise scams a significant share. Container scams are part of that picture, and they grew during the 2021 supply shock when buyers were desperate. The market normalized but the scammers did not leave.
For a deeper walkthrough on what is worth pushing back on at the quote stage, our guide to negotiating honestly with a yard covers the moves that actually work.
Detailed topic guides: spokes from this hub
Go deeper on the pricing reality across container grades
This hub covers the pricing landscape. The following spokes drill into specific bands, calculators, and decision frameworks. Each one is built on the same honest-yard logic.
- One-Trip shipping container cost Ontario, the premium band, what justifies it, and when you actually need it
- Container resale cost calculator Ontario, math for what a used unit is honestly worth
- Shipping container price negotiation Ontario, how an honest yard quotes and what to push back on
- Container age buying framework: 8-year vs 15-year Ontario, when paying more for younger steel pays off
- Shipping container scrap value Ontario, the floor under every used container price
- Shipping container auction prices Canada, what wholesale and auction inventory actually trades for
- Refurbished shipping container vs new Ontario, the middle path between One-Trip and WWT
- Shipping container condition grading system Canada, the IICL framework that sits behind every grade label
Frequently asked questions
How much does a 20ft shipping container cost in Canada in 2026?
A 20ft container in Canada in 2026 spans four grade bands, from As-Is at the bottom up to One-Trip at the top. Wind & Watertight is the most common choice for stationary storage, with Cargo Worthy sitting a step above it. Delivery is quoted separately and varies by distance and region. Send us the grade and your postal code for a real number.
How much does a 40ft shipping container cost in Canada in 2026?
A 40ft Standard in 2026 spans the same four grades as the 20ft, from As-Is up to One-Trip. The 40ft High Cube, the most popular size globally, runs higher than the Standard across every grade because of demand and the extra foot of headroom. Wind & Watertight is the working-band default for 40ft storage. Tell us the grade and postal code for a real quote.
Why is a One-Trip container so much more expensive than a used one?
One-Trip containers carry a 50 to 75 percent premium over used units because they are essentially new: single ocean crossing, original factory paint, 25-plus year expected lifespan, and resale value that holds. Used CW and WWT units have multiple crossings, cosmetic wear, and lower resale.
Has the container market gone back to pre-pandemic prices?
Roughly, yes. 2026 pricing is back to pre-2020 levels adjusted for steel inflation, well below the 2021 peak when 40ft One-Trip units roughly doubled their pre-pandemic price. The market is stable now, with 3 to 4 percent annual growth forecast and occasional spikes from canal disruptions.
Is the container cheaper in Quebec or BC than in Ontario?
Quebec and BC frequently land used containers 5 to 10 percent below Ontario because of Port of Montreal and Port of Vancouver intake. Ontario inventory is denser but freight-included pricing tends to be similar once you factor in inland delivery to your site.
How much extra does a High Cube container cost vs Standard?
A High Cube carries a modest premium over its Standard counterpart, the size of which depends on grade and size. The extra foot of interior headroom (9 feet 6 inches vs 8 feet 6 inches) makes HC the global default for the 40ft size and increasingly common for 20ft as well.
How much does a refrigerated (reefer) container cost?
A reefer costs several times what its dry-container equivalent does, with the 40ft HC reefer the most expensive of the common sizes. The refrigeration unit (Carrier or Thermo King) carries most of the premium. Reefer prices are driven by the condition of that unit far more than by the steel around it.
What does container modification cost on top of the unit price?
Modification adds a layer on top of the unit price that grows with scope. A basic conversion (one door, one window, paint) is the smallest. A mid-tier conversion (insulation, electrical, HVAC, framing) is larger. A full container home or office is the largest by far. In every case the container itself is the smallest line in the budget.
What is the lowest honest price for a 20ft container in 2026?
The honest floor for a 20ft container in 2026 is an As-Is unit with known structural issues (floor damage, frame distortion, or major rust). Anything priced well below the going As-Is band is either a scrap-only unit or, more likely, a scam.
Do container prices include delivery?
Honest quotes list unit price and delivery as separate lines. A quote that says ‘delivered’ without breaking out the freight is hiding the variable. Delivery in Ontario from our Brantford yard is quoted by distance and tilt-deck access, so you can see exactly what the freight costs.
How can I tell if a container listing is a scam?
Six red flags: price more than 25 percent below market band, no physical yard address, Interac e-Transfer only, generic or stolen photos, urgency pressure, no paperwork. Two of these mean caution. Three mean walk. Call the supplier and ask to visit the yard before paying.
Where can I see Van Blanc’s container pricing in person?
Van Blanc operates from four Brantford yards. Buyers across Ontario regularly drive to view bins before they pay. We deliver in 1 to 3 days across Ontario, with every quote including a real lead time, not a hopeful one. Call 519-754-6844 to book a yard visit.
How much does it cost to rent a shipping container in Canada?
Rental cost is set by size, term length, condition tier, delivery and pickup distance, and season. Short terms carry the highest effective monthly rate; long terms flip the math toward buying, with national programs publishing break-even points around 20 to 27 months. The full driver breakdown is in our storage container rental cost guide. Call 519-754-6844 for a real monthly number.
Can I rent-to-own a shipping container in Ontario?
Yes. Van Blanc offers rent-to-own on standard sizes: payments over a defined term with ownership at the end and an early-payoff option. It suits buyers who need the box now and prefer to spread the cost. How the term math works is covered in our rent-to-own guide.
Sources
- Ontario Construction News. (2026). Shipping container pricing in Canada: A 2026 guide for construction professionals. ontarioconstructionnews.com
- Metropolitan Logistics. (2026). Shipping Container Sizes and Prices in Canada: Complete 2026 Buyer & Shipping Guide. metropolitanlogistics.ca
- Container xChange. (2026). Shipping container price Canada: Buy new and used units. container-xchange.com
- International Organization for Standardization. (2022). ISO 6346:2022 Freight containers, Coding, identification and marking. iso.org
- International Maritime Organization. (1972, amended). International Convention for Safe Containers (CSC). imo.org
- Lummid. (2026). Shipping Container Costs in 2026: What Resellers Should Budget. lummid.com
- Canadian Anti-Fraud Centre. (2025). Annual Fraud Report. antifraudcentre-centreantifraude.ca
- Breakbulk News. (2026, July). Drewry World Container Index drops for second straight week as capacity surges and tariff deadline nears. breakbulk.news
Reach Van Blanc in Brantford
We have been supplying shipping containers across Ontario since 1995. Our warehouse is at 90 Morton Avenue E in Brantford, and we deliver right across the province with payment terms (cash, draft cheque, wire, credit card) that customers describe as some of the most honest in the industry. No surprise fees, no chase-the-paperwork.
Van Blanc Ent. Inc., 90 Morton Ave E Unit 1B, Brantford, ON N3R 7J7, +1 888-509-6658
Pricing questions are the call we love taking. Whether you need a 20ft WWT for a back-forty equipment shelter or a 40ft HC One-Trip for a retail conversion, we will quote you honest 2026 pricing with every line broken out. Worth the drive for unbeatable quality, family customer service with 30 years of experience.
